The Water Loss Claim File a DC Condo Board Should Hold

Steve Jafari, General Manager of Restoration Doctor

BYSteve Jafari, General ManagerWASHINGTON DC & SOUTHERN MARYLAND

A tabbed document set stacked on a plywood folding table in a stripped rowhouse-style corridor

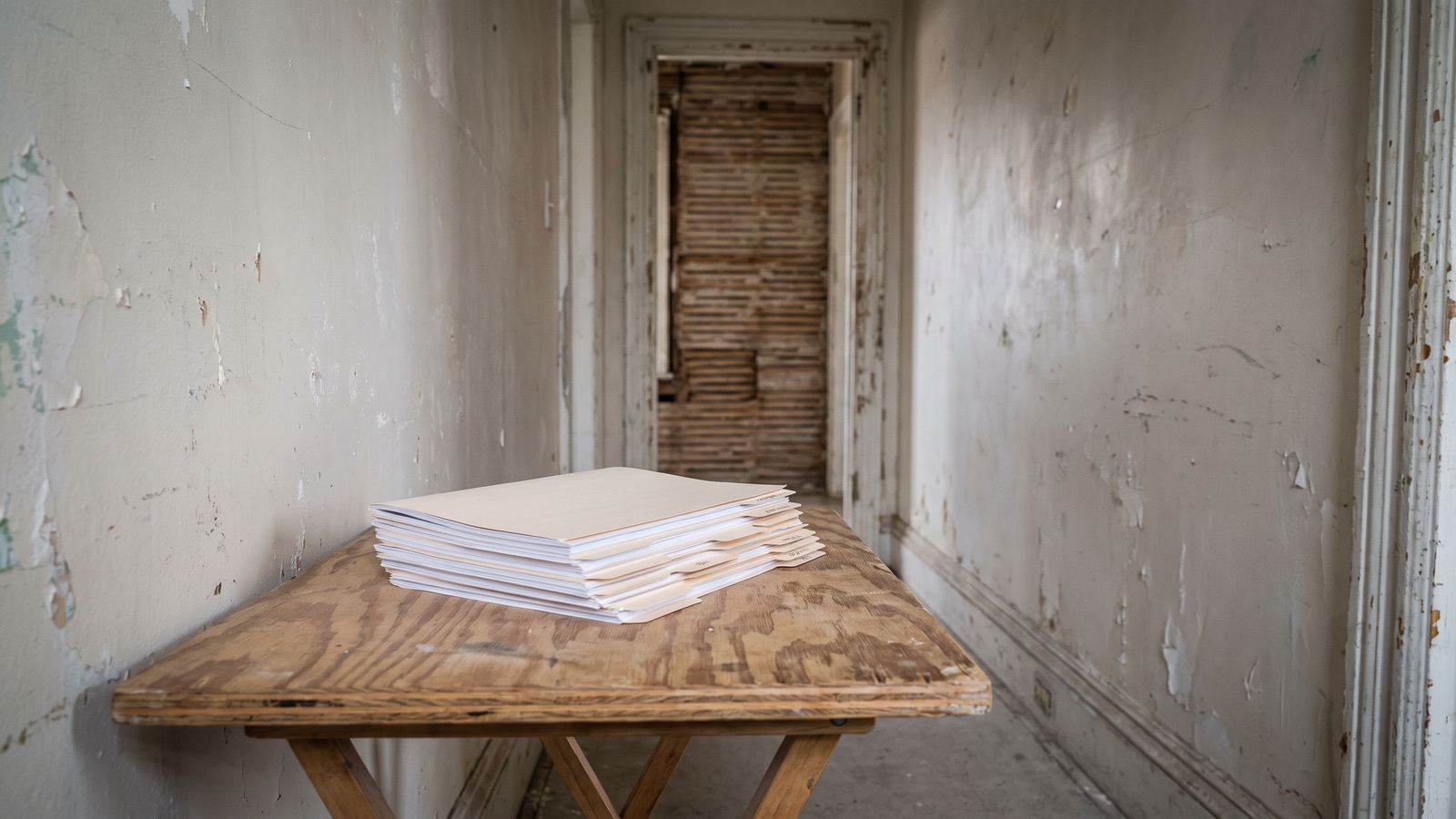

A claim file, kept as one tabbed record, holds up better than paper reassembled from memory weeks later.
TL;DR

A condo board water damage claim documentation file is strongest when it separates the loss into one record per unit while keeping a single building-level record, and when every reading, every machine and every hand-off is written down the day it happens. No District statute sets that document list, so the file is built to answer what an insurer actually asks: what was damaged in which unit, why each activity was necessary, and who let the crew in. A file reconstructed from memory weeks later convinces nobody.

Call (202) 922-1444

What belongs in a condo board water damage claim documentation file?

Condo board water damage claim documentation is the record a managed building produces while the work is happening, not the packet somebody assembles once the last fan is gone. A single supply-line failure in a vertical pipe run can touch a corridor, a stairwell and four units on three different levels, and the association and each affected unit owner may be looking at separate policies. The file has to be readable by people who were never in the building and will form their whole picture of the loss from paper.

Nothing in District law hands a board a document list. What does exist is a set of expectations you can read for yourself. The standard homeowners form contemplates keeping an accurate record of expenses and handing over records on request. The water damage restoration standard treats documentation as part of the work, not as paperwork bolted on afterward. Between those two, the shape of a defensible file is clear enough.

  • One building-level record: the authorization, the cause and origin as observed, the common-area scope, and the daily log for corridors, stairwells and mechanical spaces
  • One record per affected unit: the unit's own scope, its own moisture readings, its own equipment list and its own photographs
  • An access record that names every attempt made on a unit that did not open, with dates and times
  • A hand-off record that shows who authorized what, and when each phase started and ended
  • A close-out packet that states the drying goal each unit was compared against and what was deliberately left for the rebuild

Why does one water loss in a District building produce several records?

A loss in a detached house has one owner, one policy and one scope. A loss in a District condominium or cooperative has an association, a managing agent, a board, several residents, and at least two insurance programs pointed at the same wet drywall. The physical event is one event. The paperwork is not: each unit's questions get asked and answered separately.

Keeping the records separate from day one costs an hour of setup. Separating them afterward is close to impossible, because readings taken as one sweep of the whole building cannot be split back into units, and an equipment list that only totals the machines on site cannot tell anyone which unit carried which load for how long. That is how a multi-unit file ends up reading thin.

Which part of the loss belongs to the association and which part belongs to a unit owner is a question for the building's governing documents and for both carriers, and this post does not answer it. Our post on co-op and condo water damage in DC walks through how those structures differ, and the answer for any particular building comes from its own declaration and bylaws, read with an agent, a licensed public adjuster or counsel.

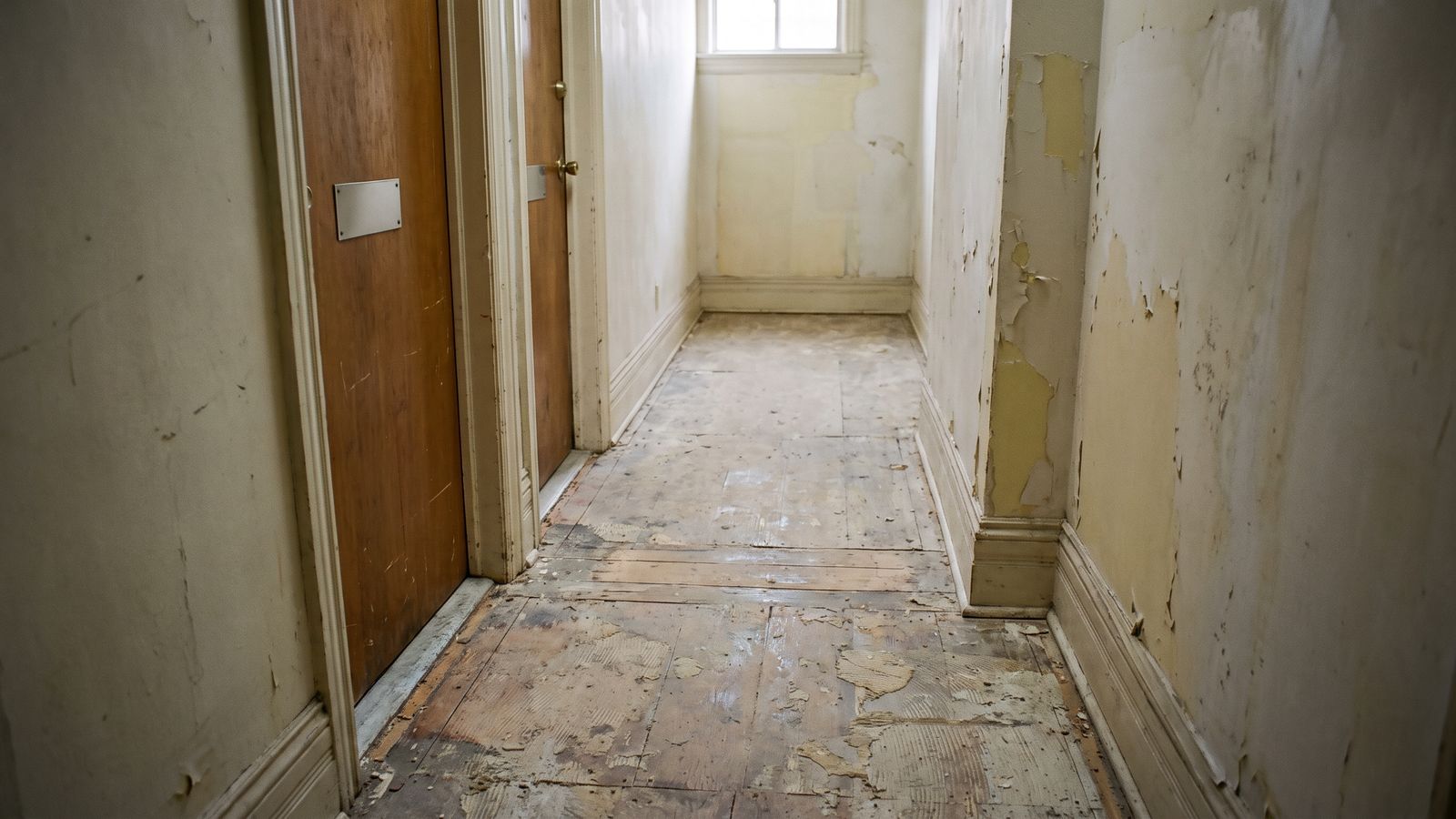

Two closed unit doors along a bare subfloor corridor with the finish flooring removed
One loss can touch several units on different levels, each with its own scope and its own record.

What does a unit-by-unit scope have to show?

A scope that only names rooms is not a scope. For each affected unit, the record should carry measured dimensions of every affected room, the material and assembly that got wet, where the moisture stopped, and a plain sentence for each activity explaining why it was necessary. The last part is what separates a scope from an inventory of labor: a reader who was not there needs the reason, not just the quantity.

Photographs are part of the scope, not a separate hobby. Each image should be keyed to the unit and the date, taken before work starts in that unit, again during demolition, and again at completion. Where a flood cut, meaning drywall cut away to a set height above the floor, crossed from common element into unit property, the photograph showing that boundary is worth more later than any sentence about it.

  • Room dimensions per affected unit, taken on site rather than from a plan set
  • Material and assembly: the floor build-up, the wall cavity, the insulation type, the ceiling system
  • The moisture boundary, recorded as a reading rather than a description
  • A one-line necessity note for each activity, in the words of the person who scoped it
  • Photographs keyed to unit and date, before, during and at completion

How should a board record a unit owner who will not allow access?

A unit that does not open is part of the record, not a hole in it. An unexplained gap in a drying log invites a question nobody can answer six weeks later, while a documented sequence of attempts answers it before it is asked.

Record the date and time of each attempt, how notice was given, who made it, and what the crew could observe from the corridor without entering. Keep it factual. Do not write anything about why a resident declined, and do not characterize a motive. If the delay changed the drying plan for neighboring units, note that consequence in the building-level log on the day it happened rather than in a summary written at the end.

  • Each attempt: date, time, who attempted entry, and the outcome
  • The method of notice, and a copy of the notice itself where one was posted or sent
  • What was observable from outside the unit, with a photograph where there was something to see
  • The effect on adjacent units, written in the building-level log the same day
  • Nothing about motive, and no characterization of the resident

What does the day-by-day drying record contain?

The drying record is the part of the file that shows a decision being made rather than asserted. For each day of active drying, it should carry the outside conditions, the conditions inside the affected space, readings from the wet materials themselves, and the machines running in each unit at that point. Read in sequence, those numbers explain why equipment stayed and why it came out.

The equipment record is the companion to it. A total count of machines on the property tells a reader almost nothing. A record that gives the unit, the room, the machine type, the quantity and the date it went in and came out tells them everything, and it can be checked against the readings on the same page.

  • Outside conditions and the conditions in each affected space, taken daily while equipment runs
  • Moisture readings from the affected materials, at the same points each day, in the same units of measure
  • The drying goal each material was being compared against, stated once and not moved
  • Equipment by unit and by room, with a date on and a date off for each machine
  • The date monitoring stopped in each unit, and the reading that supported stopping

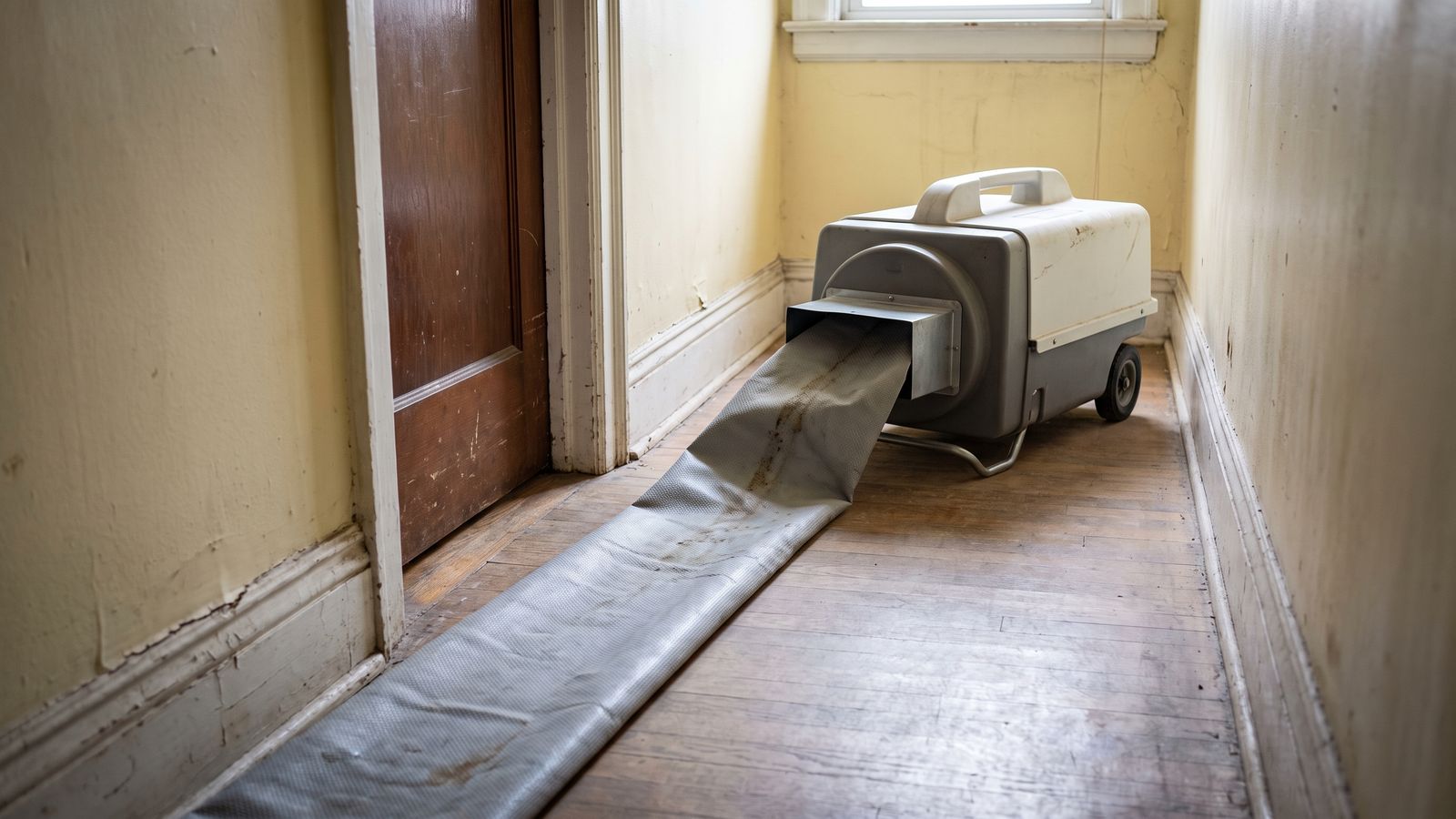

A flat drying duct runs along a corridor floor past an open doorway to a dehumidifier by the window
Equipment placed, moved or removed is one of the hand-offs worth logging by unit, room and date.

How do coordination hand-offs get captured while the work is happening?

Most of what goes wrong in a multi-unit file is not a missing photograph. It is a hand-off nobody wrote down. A board authorizes emergency work by text and nobody keeps the text. A resident lets a crew in and no one records who. Drying ends in one unit before the rest and the release is never noted. Each of those is a two-line entry on the day, and an unanswerable question afterward.

The table below is the set of hand-offs worth treating as events in their own right. It is a documentation habit, not a rule from any statute.

Hand-offWhat the file should carryWho should already hold a copy
Board or agent authorizes emergency workThe written authorization, the date and time it was given, and the scope it coveredThe board, the managing agent and the contractor
Crew first enters a unitDate and time, who provided access, and the pre-work photographs of that unitThe contractor, with that unit's set released to its owner
A unit delays or refuses accessEach attempt, the notice method, and what was observable from the corridorThe managing agent and the contractor
Equipment placed, moved or removedUnit, room, machine type, quantity, date on and date offThe contractor, summarized to the board on a fixed day each week
Drying ends in one unit ahead of othersFinal readings, the goal they were compared against, and a dated release noteThat unit owner and the contractor
Mitigation ends and the rebuild beginsThe written scope narrative, close-out photographs, and what was left undone on purposeThe board, the agent and every unit owner in the loss
Illustrative only. What an insurer owes is decided by the policy and the facts of the loss.

Who holds which copy of the file, and what should the board minutes show?

Four parties end up holding a version of this file, and not the same version. The managing agent holds the building-level record and the access log. Each unit owner should hold their own unit's set, because their insurance conversation is theirs. The board holds what it acted on. The contractor holds the technical record it produced: the line-item estimate, the daily logs, the equipment record, the photographs and the written scope narrative.

Restoration Doctor invoices whoever signed the work authorization, the association or a unit owner, rather than either insurer. That party owes the entire invoice when the work is finished, not only a deductible, and what either carrier reimburses is settled between the policyholder and that carrier. We hand over the technical package so the policyholder can submit it and hold their own claim. We do not adjust a claim, we do not negotiate one, and we are not public adjusters. The trade body for our industry makes a related point worth a board knowing. Absent a direct contract with an insurer, a restoration contractor is under no legal obligation to that insurer, its adjuster or a third party. Unless an insurer's consultant's opinions are agreed by the contractor and the customer and written into the restoration contract or the scope of work, the trade body's position is that they have no effect on the contractor's duties and are not binding on it.

Minutes do not need the technical detail, and they are not the place for it. What minutes can usefully show is that the board saw the scope, understood what it was authorizing and when, and recorded the decision or the delegation that authorized it. The form those minutes take is a matter for the association's governing documents and its counsel.

What explanation can a District policyholder ask an insurer to provide?

The District's unfair claim settlement practices section sets out two lists of practices, and the opening words of each list matter as much as the items on it. Two of the items are about explanations. One is failing "promptly upon request to provide a reasonable explanation of the basis for a denial of a claim". The other is failing, on a denial or an offer of compromise settlement, "to promptly provide a reasonable and accurate explanation of the basis for such action".

Read the opening words of both lists before relying on either, because they change what the section is. Each subsection begins: "No person shall commit or perform with such frequency as to indicate a general business practice any of the following". That threshold is about a pattern of conduct, not a single event. One letter a board finds thin is not a violation of this section, and the Commissioner rather than the policyholder is the enforcer. The section also sets no number of days for anything.

What the list is genuinely useful for is shaping written requests. It tells a board and a unit owner which questions an insurer should expect to answer on paper, and a file organized unit by unit can hold the answers next to the scope they refer to. The two explanation items reach a denial and an offer of compromise settlement. Neither list requires an insurer to hand over its own estimate, and no District regulation requiring that was located, so the requests below are requests rather than entitlements. What to do when a claim is actually denied is covered in our post on who pays the restoration company in DC.

  • Ask in writing for the insurer's own estimate for the loss, and for the revised version if it changes, knowing no located District rule compels one
  • Ask for the reason given for any activity removed from a scope, in writing, naming the document it came from
  • Ask which policy language a decision relies on, and keep the answer with the unit record it concerns
  • Keep every request and every reply in the same file as the scope, in date order
  • The regulator's Insurance Bureau says it "addresses consumer complaints", and the section it enforces describes a pattern rather than a single letter

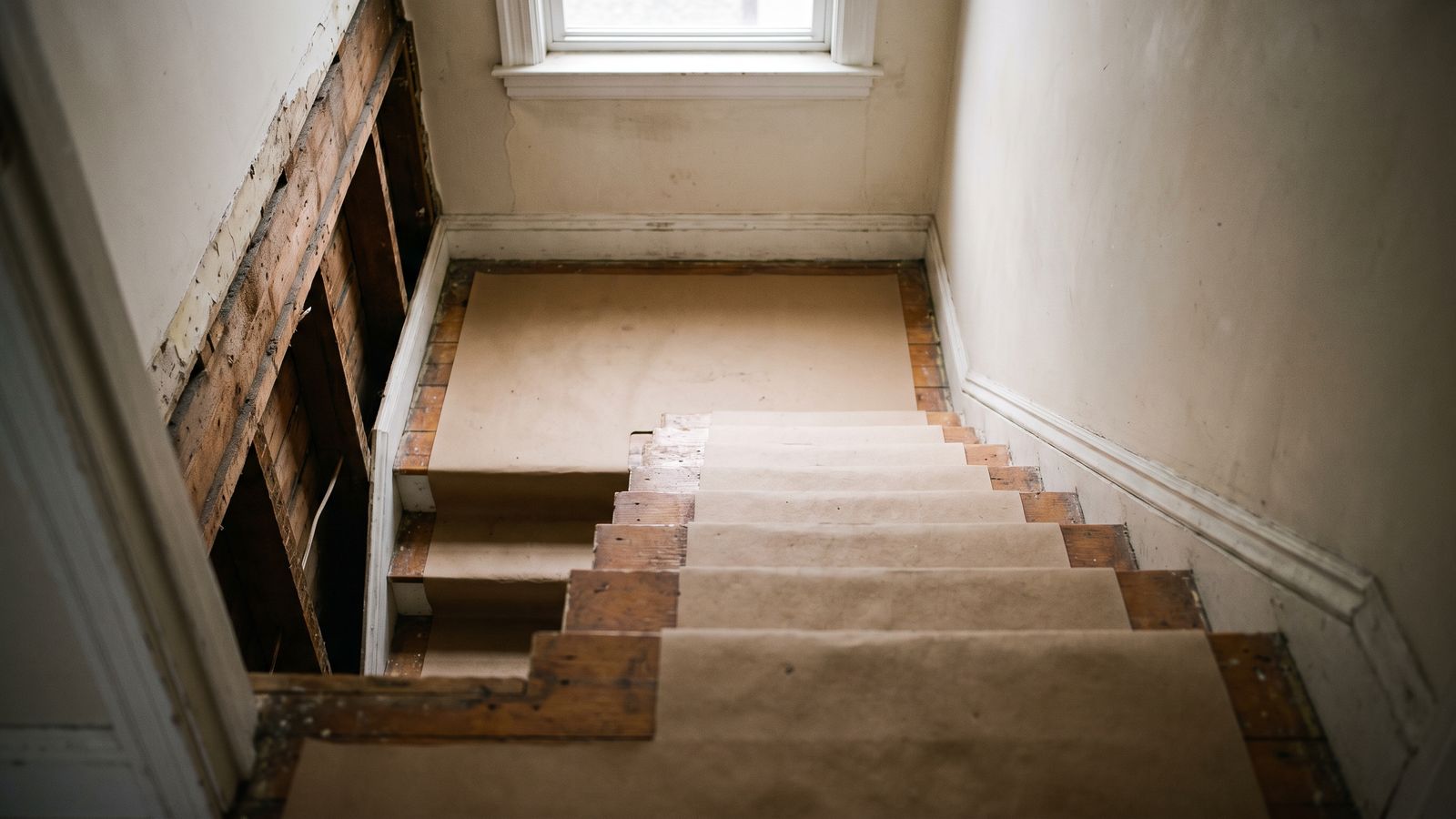

Stair treads covered edge to edge with protective paper beside a wall opened to the lath and studs
A stair and a landing are common elements with their own scope, their own readings and their own line in a close-out packet.

What should be settled before the crews leave the building?

The last day on site is the cheapest moment to close every open question, and an easy one to waste. Once the crew has moved to another job, every unanswered item becomes a phone call, and the file freezes in whatever state it was in. Ten minutes with the site supervisor and the managing agent settles most of it.

Ask for the close-out packet in writing before the crews leave, and ask which items are still open. A contractor that documents well will have most of it assembled already.

  • The final reading for each unit and the drying goal it was compared against
  • The date equipment came out of each unit, unit by unit, not as a single building date
  • Photographs of every area at completion, keyed to the unit
  • The written scope narrative explaining why each activity was necessary
  • What was deliberately left for the rebuild, and what is still being monitored
  • Where the disposal record is, and who holds the keys to any remaining containment

Where can a District board read these rules for itself?

What this post is not: Restoration Doctor is a restoration contractor, not a public adjuster and not a law firm, and nothing here is legal or insurance advice. We do not interpret anyone's policy and we do not tell a reader what theirs covers or what it requires of them. For a specific building or a specific claim, the sources below are the primary material, and an agent, a licensed public adjuster or counsel is the right reader of your own documents.

Two documents are worth reading directly. The standard homeowners form published by Insurance Services Office, in its conditions after a loss, asks the insured to protect the property and, where repairs are required, to "Keep an accurate record of repair expenses". It also contemplates providing the insurer with "records and documents we request". That is standard form text, not District law, and the policy an association or a unit owner actually holds is the one that governs. The water damage restoration standard lists "Administrative procedures, project documentation, and risk management" among the components of the work it describes.

Sources referenced in this article:

SECTION / FAQ

Frequently asked

That depends on the building's declaration and bylaws and on the two insurance programs pointed at the loss, and no article can answer it for a particular unit. Our post on co-op and condo water damage in DC explains how the structures differ. For your own building, read the governing documents with an agent, a licensed public adjuster or counsel.

One building-level record covering the authorization, the common-area scope and the daily log, plus a separate record for each affected unit holding that unit's scope, readings, equipment list and photographs. Add an access log naming every attempt on a unit that did not open, and a close-out packet stating the drying goal each unit was compared against and what was left for the rebuild.

Not in the way that question suggests. The District's unfair claim settlement practices section does list a failure to promptly provide a reasonable explanation for a denial. Each list in that section opens by reaching only conduct performed with such frequency as to indicate a general business practice. So it describes a pattern rather than one letter, and the Commissioner enforces it rather than the policyholder.

The industry's trade body has published a position on this. Third parties cannot unilaterally dictate restoration procedures, scope, price or billing. Unless a third party's opinions are agreed by the contractor and the customer and written into the restoration contract or the scope of work, the trade body says they have no effect on the contractor's duties and are not binding on it. Absent a direct contract with an insurer, a restoration contractor owes that insurer, its adjuster or a third party no legal obligation.

Both hold part of it. The contractor holds the technical record it produced: the estimate, the daily logs, the equipment record, the photographs and the scope narrative. The association holds what it authorized and acted on, and each unit owner should hold their own unit's set. Ask for the unit sets to be released separately rather than as one building-wide bundle.
